How to Price a Roofing Job: Complete 2025 Guide + Free Calculator

July 2, 2025 - 24 min read

TL;DR

Pricing roofing jobs correctly in 2025 requires calculating material costs, labor expenses, overhead, and applying a 20-40% profit margin. This guide shows exactly how to estimate every cost, avoid underbidding mistakes, and win more profitable jobs using proven formulas and FieldCamp’s integrated pricing tools.

The roofing industry is experiencing explosive growth. The US roofing market reached $23.35 billion in 2023 and is projected to grow at 6.6% CAGR through 2032 (ConsumerAffairs, 2024; Mordor Intelligence, 2024). Yet the average roofing contractor operates on just 15% profit margins (SharpSheets, 2024).

Why are contractors struggling to capture their share of this booming market? Poor pricing strategies. With 61% of contractors citing labor shortages as their biggest challenge and material costs rising annually, many roofing business owners still rely on guesswork instead of proven formulas.

This comprehensive service pricing guide reveals the exact frameworks successful contractors use to price jobs profitably. You’ll master cost calculations, markup strategies, and commercial pricing strategies while leveraging tools like our free service price calculator for accurate estimates. Stop leaving money on the table—start pricing with confidence and building the profitable roofing business you deserve.

Why Accurate Roofing Pricing Matters?

The roofing industry is experiencing unprecedented challenges in 2025. Recent industry reports estimate the U.S. home roofing services market at $15 billion in 2025, with strong growth projected, but competition is fierce with over 79,000 roofing contractors nationwide.

the-cost-of-getting-pricing-wrong

The Cost of Getting Pricing Wrong:

Underbidding Consequences:

  • Cash flow problems from razor-thin margins
  • Inability to pay for quality materials or skilled labor
  • Working overtime just to break even
  • No funds for business growth or equipment upgrades

Overbidding Risks:

  • Lost jobs to lower-priced competitors
  • Reputation damage in local markets
  • Reduced referral opportunities
  • Seasonal revenue drops

The average profit margin for roofing companies typically ranges between 20% to 40%, but achieving consistent profitability requires understanding every cost component that goes into a roofing project.

Track Every Dollar with FieldCamp

Stop leaving money on the table with manual estimates. FieldCamp’s integrated pricing tools help you calculate materials, labor, and overhead automatically, ensuring every quote protects your profit margins.

  • Real-time material cost tracking
  • Labor hour logs for activity tracking
  • Built-in profit margin calculator

Common Roofing Pricing Models

Choosing the right pricing model is crucial for both profitability and customer satisfaction.

common-roofing-pricing-models

Here are the most effective approaches used by successful roofing contractors:

1. Hourly Rate Pricing

How it works: Charge customers based on total labor hours multiplied by your hourly rate, plus materials.

Formula: Total Price = (Labor Hours × Hourly Rate) + Material Costs + Overhead + Profit

Example:

  • 40 labor hours × $75/hour = $3,000
  • Materials: $8,500
  • Overhead (25%): $2,875
  • Total before profit: $14,375
  • With 20% profit margin: $17,969
Best ForAvoid When
Complex or unpredictable jobsCustomer wants fixed pricing
First-time clients where scope isn’t clearStandard residential replacement jobs
Renovation work with unknown variablesCompetitive bidding situations

2. Flat Rate Pricing

How it works: Set a fixed price for the entire roofing project regardless of time spent.

Formula: Flat Rate = Total Costs × (1 + Desired Profit Margin %)

Example:

  • Estimated costs: $12,000
  • Desired 25% profit margin
  • Final price: $12,000 ÷ 0.75 = $16,000
Best ForAvoid When
Standard roofing servicesJob scope is unclear
Experienced contractors with accurate time estimatesWorking with unfamiliar materials
Customers who prefer price certaintySignificant site access challenges

3. Square Footage Pricing

How it works: Price based on total roof area using per-square-foot rates.

Roofing labor costs $2.00 to $3.50 per square foot on average or $200 to $350 per square to install shingles, not including materials and supplies.

Formula: Total Price = Roof Area (sq ft) × Rate per Square Foot

Material Cost Ranges by Type:

  • Asphalt Shingles: $4.83-$6.29 per sq ft (Homewyse, 2025)
  • Metal Roofing: $7.50-$15.00 per sq ft (IBISWorld, 2024)
  • Tile Roofing: $8.00-$18.00 per sq ft (Roofing Contractor, 2024)

✅ Best for:

  • Quick estimates and ballpark pricing
  • Standard material installations
  • New construction projects

How to Calculate Roofing Material Costs?

Material costs typically represent 30-35% of total roofing project costs. Accurate estimation requires understanding current market prices and accounting for waste and delivery.

Primary Roofing Materials

Asphalt Shingles

You can expect to spend anywhere from $5,840 to $10,100 to replace your entire roof with asphalt shingles.

  • 3-Tab Shingles: $3.43-$4.65 per sq ft (National Average, 2025)
  • Architectural Shingles: $4.11-$5.57 per sq ft (Roofing Calculator, 2025)
  • Premium Architectural: $4.39-$5.95 per sq ft (This Old House, 2025)

Metal Roofing

  • Corrugated Aluminum: $6.03-$8.15 per sq ft (This Old House, 2025)
  • Metal Shingles: $7.69-$10.41 per sq ft (Roofing Calculator, 2025)
  • Standing Seam: $18.11-$24.50 per sq ft (Polyglass, 2024)

Other Materials

  • Wood Shingles: $400-$700 per square (Joist, 2025)
  • Clay Tiles: $500-$1,200 per square (HomePro, 2024)
  • Slate: $800-$1,600 per square (Angie’s List, 2024)

Wondering how much roof or surface proofing will cost?

Try our free roofing price calculator — just enter your area, select the service type, and get an instant estimate. It’s quick, accurate, and perfect for budgeting before the real work begins.

Secondary Materials and Supplies

Don’t forget these essential components:

  • Underlayment: $0.10-$0.80 per sq ft (HomeGuide, 2024)
  • Flashing: $8-$20 per linear foot (Contractor Pricing, 2024)
  • Ridge Cap Shingles: $3-$8 per linear foot (Material Suppliers, 2024)
  • Nails/Fasteners: $50-$150 per project (Industry Standard)
  • Drip Edge: $2-$5 per linear foot (Building Supply, 2024)

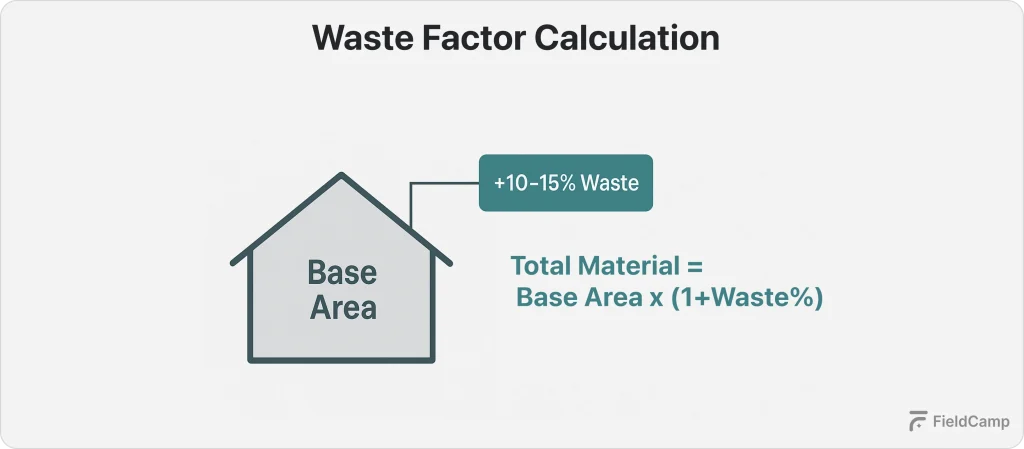

Waste Factor Calculation

waste-factor-calculation

Always add 10-15% for material waste:

  • Simple roof: 10% waste factor
  • Complex roof with multiple angles: 15% waste factor

Example Calculation:

  • Base material needed: 2,500 sq ft
  • Waste factor: 12%
  • Total materials to order: 2,500 × 1.12 = 2,800 sq ft

Estimating Labor Costs

Labor costs typically account for 30-40% of total roofing project costs. Accurate labor estimation requires understanding local wage rates, productivity factors, and job complexity.

labor-cost-breakdown

Determining Your Base Labor Rate

#Step 1: Calculate True Hourly Cost

Don’t just use the worker’s wage—include all labor-related expenses:

Formula: True Hourly Cost = (Base Wage + Burden) × Efficiency Factor

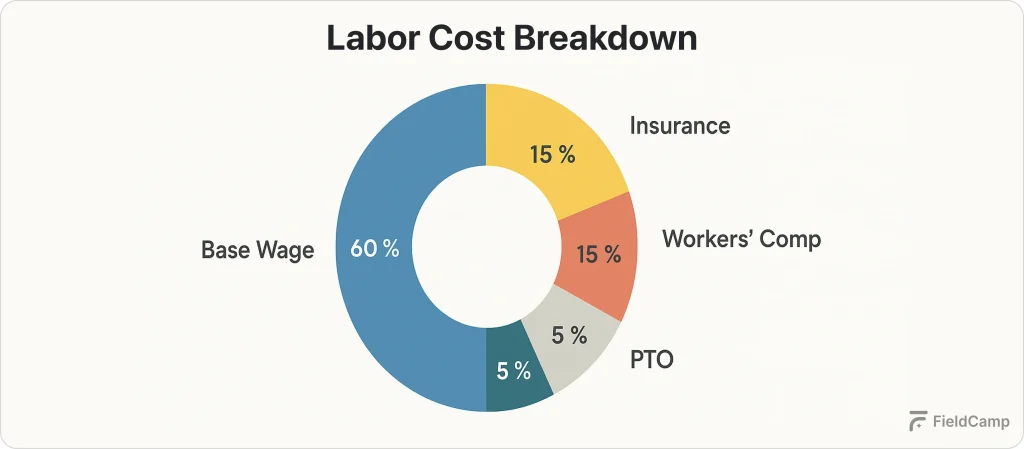

Labor Burden includes:

  • Payroll taxes (7.65% FICA minimum)
  • Workers’ compensation insurance (varies by state)
  • Unemployment insurance
  • Health insurance contributions
  • Paid time off
  • Equipment and tool costs

Example Calculation:

  • Roofer base wage: $25/hour
  • Labor burden (35%): $8.75/hour
  • True cost: $33.75/hour
  • Efficiency factor (80%): $33.75 ÷ 0.80 = $42.19/hour

Free Tool:

Stop guessing and start pricing with precision with FieldCamp’s free labor cost calculator. Quickly factor in wages, burdens, and efficiency to get your real labor cost per hour.

Regional Labor Rate Variations

Roofers charge $30 to $100 per hour for labor, with significant regional differences:

High-Cost Areas (Urban): $60-$100/hour

  • California, New York, Washington DC metro
  • Major metropolitan areas

Moderate-Cost Areas: $45-$75/hour

  • Mid-sized cities, suburban markets
  • Texas, Florida, Colorado

Lower-Cost Areas: $30-$55/hour

  • Rural markets, smaller cities
  • Midwest, Southeast regions

Labor Hours by Roof Type

Asphalt Shingle Installation:

  • Simple roof: 1.5-2.5 hours per square
  • Complex roof: 2.5-4 hours per square

Metal Roofing:

  • Standing seam: 3-5 hours per square
  • Corrugated metal: 2-3 hours per square

Tile Installation:

  • Clay/concrete tile: 4-6 hours per square
  • Slate installation: 5-8 hours per square

Roof Pitch Multiplier

Steeper roofs require more time and safety equipment:

Roof PitchMultiplierSafety Requirements
4/12 or less1.0Standard equipment
5/12 to 6/121.1Additional safety gear
7/12 to 9/121.2Harnesses, scaffolding
10/12 to 12/121.4Advanced fall protection
Over 12/121.6+Specialized equipment

Labor Calculation Example:

  • Base roof: 25 squares
  • Standard installation: 2 hours per square = 50 hours
  • Roof pitch 8/12: 50 × 1.2 = 60 hours
  • Labor rate: $65/hour
  • Total labor cost: 60 × $65 = $3,900

Understanding Overhead Costs

The conventional wisdom often suggests that your overhead should be between 25% to 30% of your revenue. However, many contractors fail to properly account for all overhead expenses, leading to reduced profitability.

overhead-breakdown

Direct vs. Indirect Overhead

Direct Overhead (Job-Specific):

  • Equipment rental and fuel costs
  • Transportation costs to job site
  • Permits and inspections
  • Disposal fees for old materials
  • Site protection and cleanup

Indirect Overhead (Business Operations):

  • Office rent and utilities
  • Insurance premiums (liability, bonding)
  • Vehicle payments and maintenance
  • Tools and equipment depreciation
  • Marketing and advertising costs
  • Administrative salaries
  • Software subscriptions and technology

Calculating Overhead Per Job

#Method 1: Percentage of Revenue

If annual overhead is $150,000 and annual revenue is $600,000:

Overhead rate = $150,000 ÷ $600,000 = 25%

#Method 2: Per Labor Hour

If monthly overhead is $12,500 and you work 500 labor hours per month:

Overhead per hour = $12,500 ÷ 500 = $25/hour

#Method 3: Per Project

For a job requiring 40 labor hours:

Overhead allocation = 40 hours × $25/hour = $1,000

Overhead Cost Breakdown

Typical Overhead Percentages by Category:

  • Vehicle and equipment: 6-8% of revenue
  • Insurance and bonding: 3-5% of revenue
  • Office and administrative: 4-6% of revenue
  • Marketing and sales: 2-4% of revenue
  • Professional services: 1-3% of revenue

Hidden Overhead Costs

Many contractors forget these expenses:

Technology Costs:

  • Estimating software: $50-$200/month
  • Accounting software: $30-$100/month
  • Mobile apps and tools: $20-$80/month

Professional Development:

  • Training and certifications: $1,000-$3,000/year
  • Industry memberships: $200-$500/year
  • Trade show attendance: $500-$2,000/year

Transportation Costs:

Costs for local material/equipment delivery to and service provider transportation to and from the job site add up quickly:

  • Fuel costs: $0.25-$0.45 per mile
  • Vehicle maintenance: $0.15-$0.25 per mile
  • Commercial insurance: $100-$300/month per vehicle

Profit Margin and Markup Strategies

Understanding the difference between profit margin and markup is crucial for profitable pricing. Many contractors confuse these concepts and unknowingly reduce their profits.

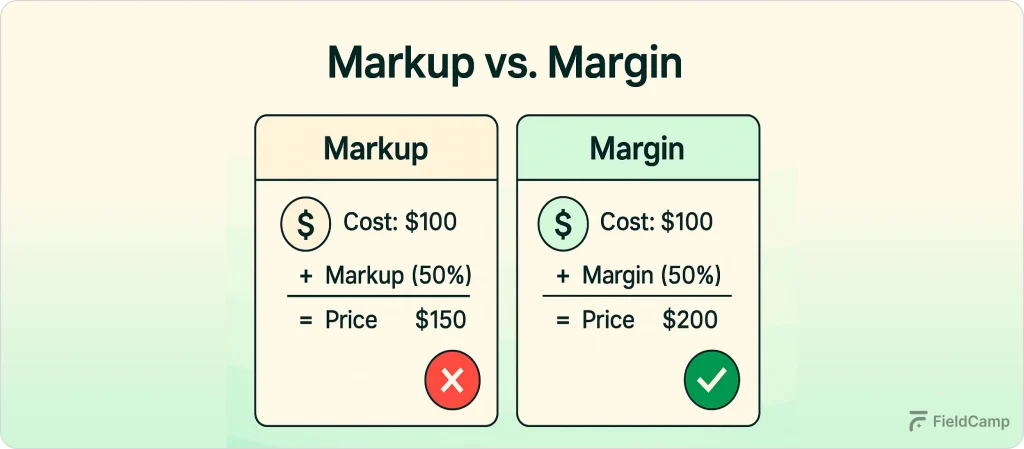

Profit Margin vs. Markup

Profit Margin = (Selling Price – Cost) ÷ Selling Price × 100

Markup = (Selling Price – Cost) ÷ Cost × 100

Profit must be calculated as a percentage not of cost, but of the final selling price.

Example:

  • Job cost: $10,000
  • Desired 20% profit margin
  • Incorrect calculation: $10,000 × 1.20 = $12,000 (only 16.7% margin)
  • Correct calculation: $10,000 ÷ 0.80 = $12,500 (20% margin)

Free Tool:

Take the guesswork out of your pricing. Whether you’re estimating a one-off roof repair or a full-scale replacement, our free profit margin calculator helps you pinpoint true profit margins and markups in seconds.

Industry Standard Profit Margins

The average gross profit margin in the roofing industry is between 20 and 40 percent.

Profit Margin Targets by Business Size:

  • Small contractors (1-5 employees): 25-35%
  • Medium contractors (6-20 employees): 20-30%
  • Large contractors (20+ employees): 15-25%

Markup Conversion Chart:

Desired Profit MarginRequired Markup
15%17.6%
20%25.0%
25%33.3%
30%42.9%
35%53.8%

Step-by-Step Roofing Job Pricing Process

Follow this proven 9-step process to create accurate, profitable roofing estimates every time:

step-by-step-pricing-process

#Step 1: Conduct Site Assessment

Pre-Visit Preparation:

  • Review customer requirements via phone
  • Check permits and building codes
  • Verify insurance requirements

On-Site Inspection:

  • Measure roof dimensions accurately
  • Assess roof pitch using digital tools
  • Identify access challenges
  • Document existing conditions with photos
  • Note utility lines and safety hazards

Assessment Documentation:

Use FieldCamp’s file management to capture:

  • Roof measurements and pitch angles
  • Material conditions and defects
  • Site access photos
  • Customer preferences and requirements

#Step 2: Calculate Roof Area

Basic Formula: Length × Width = Ground Floor Area

Adjust for Roof Pitch: Ground Area × Roof Pitch Multiplier = Actual Roof Area

Roof Pitch Multiplier Chart:

PitchRise/RunMultiplier
3/123:121.03
4/124:121.05
5/125:121.08
6/126:121.12
7/127:121.16
8/128:121.20
9/129:121.25
10/1210:121.30
12/1212:121.41

Example Calculation:

  • Ground floor: 40′ × 30′ = 1,200 sq ft
  • Roof pitch: 7/12
  • Actual roof area: 1,200 × 1.16 = 1,392 sq ft
  • In squares: 1,392 ÷ 100 = 13.92 ≈ 14 squares

#Step 3: Calculate Material Costs

Primary Materials:

  • Shingles: 14 squares × $350/square = $4,900
  • Underlayment: 1,392 sq ft × $0.45 = $626
  • Ridge cap: 60 linear feet × $5 = $300

Secondary Materials:

  • Flashing: $250
  • Nails and fasteners: $125
  • Drip edge: $180

Waste Factor (12%): ($4,900 + $626) × 0.12 = $663

Total Materials: $4,900 + $626 + $300 + $250 + $125 + $180 + $663 = $7,044

#Step 4: Estimate Labor Hours

Base Labor Hours:

  • 14 squares × 2.5 hours/square = 35 hours

Complexity Adjustments:

  • Roof pitch 7/12: 35 × 1.16 = 40.6 hours
  • Access challenges: +10% = 44.7 hours
  • Total estimated hours: 45 hours

#Step 5: Calculate Labor Costs

Labor Rate Calculation:

  • Base wage: $28/hour
  • Labor burden (35%): $9.80/hour
  • True hourly cost: $37.80/hour
  • Billable rate: $65/hour

Total Labor Cost: 45 hours × $65 = $2,925

#Step 6: Add Overhead Costs

Overhead Calculation:

  • Method: 25% of revenue
  • Direct job costs: $7,044 + $2,925 = $9,969
  • Overhead allocation: $9,969 × 0.25 = $2,492

#Step 7: Apply Profit Margin

Target 25% Profit Margin:

  • Total costs: $9,969 + $2,492 = $12,461
  • Required markup: 33.3%
  • Final price: $12,461 × 1.333 = $16,612

#Step 8: Market Comparison

Compare your price against:

  • 3-5 competitor estimates
  • Regional pricing averages
  • Customer budget expectations

Adjustment factors:

  • If 20%+ above market: Consider value justification
  • If 20%+ below market: Verify all costs included

#Step 9: Create Professional Estimate

Include these elements in your roofing estimate:

  • Detailed scope of work
  • Material specifications and quantities
  • Labor breakdown and timeline
  • Permit and disposal costs
  • Payment terms and schedule
  • Warranty information

Regional Pricing Considerations

Roofing costs vary significantly across different regions due to local economic factors, climate conditions, and regulatory requirements.

regional-pricing-differences

High-Cost Regions

West Coast (California, Washington, Oregon):

  • Labor rates: $75-$120/hour
  • Material markup: 25-35% above national average
  • Strict environmental regulations increase costs
  • Seismic and fire safety requirements

Northeast (New York, Massachusetts, Connecticut):

  • Labor rates: $65-$100/hour
  • High cost of living drives up overhead
  • Winter weather limits working season
  • Union labor requirements in some areas

Major Metropolitan Areas:

  • Labor rates: $60-$95/hour
  • Higher insurance and licensing costs
  • Traffic and parking challenges increase time
  • Premium for experienced urban contractors

Moderate-Cost Regions

Southeast (Florida, Georgia, North Carolina):

  • Labor rates: $45-$70/hour
  • Hurricane building codes require premium materials
  • Year-round working season
  • Competitive market drives efficiency

Southwest (Texas, Arizona, Nevada):

  • Labor rates: $40-$65/hour
  • Extreme heat requires early morning scheduling
  • Hail damage creates seasonal demand spikes
  • Energy efficiency requirements

Mountain West (Colorado, Utah, Wyoming):

  • Labor rates: $50-$75/hour
  • Snow load requirements increase material costs
  • Seasonal weather limitations
  • Altitude affects worker productivity

Lower-Cost Regions

Midwest (Ohio, Indiana, Illinois):

  • Labor rates: $35-$55/hour
  • Lower overhead costs
  • Seasonal weather variations
  • Conservative customer expectations

Rural Markets:

  • Labor rates: $30-$50/hour
  • Lower overhead and competition
  • Transportation costs to remote jobs
  • Limited skilled labor availability

Climate-Specific Considerations

Hurricane Zones:

  • Impact-resistant materials required
  • Higher insurance costs
  • Storm damage seasonal demand
  • Building code compliance critical

Snow Load Areas:

  • Reinforced structural requirements
  • Ice dam prevention systems
  • Limited winter working season
  • Snow removal accessibility

High Wind Areas:

  • Enhanced fastening requirements
  • Wind-resistant material specifications
  • Insurance rating considerations
  • Local code compliance

Common Pricing Mistakes to Avoid

Learn from these costly mistakes that drain profits from roofing businesses:

#Mistake 1: Confusing Markup with Profit Margin

The Mistake: Adding 20% to costs thinking it creates 20% profit margin.

The Reality: In reality, they are factoring in a net profit margin of only 9 percent and coming up short by more than $11 for every $1,000 in job cost.

The Fix: Always calculate profit as percentage of selling price, not cost.

#Mistake 2: Forgetting Hidden Costs

Commonly Overlooked Expenses:

  • Permit and inspection fees: $150-$500
  • Disposal and cleanup costs: $300-$800
  • Equipment rental: $200-$600 per job
  • Transportation costs beyond local area
  • Weather delays and rescheduling

The Fix: Create a comprehensive checklist of all potential costs.

#Mistake 3: Underestimating Time Requirements

Time Drains Not Accounted For:

  • Site setup and cleanup: 2-4 hours
  • Material loading and positioning: 1-3 hours
  • Weather delays: 10-20% of schedule
  • Correcting installation issues: 5-15% of time

The Fix: Track actual time on completed jobs to improve future estimates.

common-pricing-mistakes

#Mistake 4: Inconsistent Overhead Allocation

The Problem: Applying overhead randomly or not at all.

The Solution: Calculate precise overhead rate using one of these methods:

  • Percentage of annual revenue (25-30%)
  • Per labor hour ($15-$35/hour)
  • Per project based on size and complexity

#Mistake 5: Seasonal Pricing Mistakes

Peak Season Errors:

  • Not charging premium rates when demand is high
  • Accepting low-margin jobs during busy periods
  • Failing to book quality jobs for off-season

Off-Season Errors:

  • Cutting prices below break-even to stay busy
  • Not promoting maintenance and repair services
  • Missing opportunities for commercial work

#Mistake 6: Material Cost Miscalculations

Common Errors:

  • Using outdated material prices
  • Forgetting delivery charges
  • Inadequate waste factor calculations
  • Not accounting for material price increases

Best Practices:

  • Update material costs monthly
  • Build in 5-10% price increase buffer
  • Confirm delivery costs before quoting
  • Add appropriate waste factors for job complexity

#Mistake 7: Geographic Pricing Failures

Local Market Mistakes:

  • Using national averages for local markets
  • Not researching competitor pricing
  • Failing to adjust for regional cost differences
  • Ignoring local building code requirements

The Fix: Research local market rates quarterly and adjust pricing accordingly.

#Mistake 8: Technology and Efficiency Oversights

Missing Opportunities:

  • Manual measurement and calculation errors
  • Time wasted on administrative tasks
  • Poor communication causing delays
  • Inefficient scheduling and routing

Modern Solutions: Advanced field service management platforms like FieldCamp eliminate these inefficiencies by automating estimates, optimizing schedules, and streamlining operations.

Stay ahead of market changes that impact your pricing strategy:

Material Cost Inflation

The latest report from The Freedonia Group shows residential roofing spending projected to rise at an 8.2% annual rate reaching $15 billion by 2025.

Price Increases by Material Type:

  • Asphalt shingles: 5-8% annually
  • Metal roofing: 8-12% annually
  • Specialty materials: 10-15% annually

Mitigation Strategies:

  • Build 5-10% price escalation into long-term contracts
  • Negotiate fixed pricing with suppliers for 60-90 days
  • Offer material alternatives when costs spike

Labor Shortage Impact

By far, the biggest challenge facing commercial contractors is the lack of qualified workers; 61% said it was an issue.

According to reports done from the U.S. Census Bureau, the industry is short about 500,000 workers – specifically individuals with skilled trades experience.

Wage Pressure Points:

  • Experienced roofers commanding premium wages
  • Overtime costs during peak season
  • Training costs for new workers
  • Competition from other trades

Response Strategies:

  • Invest in employee retention programs
  • Offer competitive benefits packages
  • Partner with trade schools for apprentices
  • Implement productivity-enhancing technology

Technology Adoption

Efficiency Gains:

  • Drone roof inspections reduce assessment time
  • Mobile apps eliminate paperwork delays
  • AI-powered scheduling optimizes crew utilization
  • Digital payment processing speeds cash flow

ROI from Technology:

  • 15-25% reduction in administrative time
  • 10-20% improvement in scheduling efficiency
  • 5-15% increase in customer satisfaction
  • Reduced errors and rework costs

Regulatory Changes

Building Code Updates:

  • Enhanced wind resistance requirements
  • Energy efficiency mandates
  • Fire-resistant material specifications
  • Environmental compliance standards

Impact on Pricing:

  • Premium materials increase project costs
  • Additional training and certification costs
  • Compliance documentation requirements
  • Insurance and bonding adjustments

Frequently Asked Questions

How do you price a roofing job accurately?

To price a roofing job, calculate material costs, labor costs, and overhead expenses. Add your desired profit margin percentage and ensure your roofing estimate includes everything from roofing shingles to transportation costs and permits. Use roofing estimate templates for consistency.

What are the main costs in a roofing project?

Your total cost includes: Roofing materials (e.g., asphalt shingles, metal roofing, ridge cap shingles), Labor hours and rates, Overhead costs like tools, insurance, fuel costs, and rental costs, Transportation costs and roof pitch multiplier for steeper roofs.

What’s a healthy profit margin for roofing contractors?

Most roofing companies aim for a roofing profit margin between 20–30%. Always calculate margin from the final price, not just cost. This helps build a profitable roofing business and avoid underbidding.

How do I calculate labor costs for a roofing job?

Multiply hourly wage + burden (taxes, insurance) ÷ efficiency factor. That’s your total labor cost per hour. It’s critical for roof replacement or roof installation jobs where labor costs can be 30–40% of the overall cost.

Should I use markup or margin in my roofing bid?

Use profit margin to assess how much profit you’re keeping from the selling price. Use markup to determine how much to charge above total material cost. For a 20% profit margin, your markup should be 25%.

What’s included in a professional roofing estimate?

A clear roofing proposal should include: Scope of work, Type of roofing shingles or metal roofing, Labor timeline, Overhead expenses, Warranties and terms.

How do roofing contractors handle overhead expenses?

Smart roofing contractors track everything from office space, insurance costs, to equipment depreciation. This ensures a sustainable roofing business and better roofing bid accuracy.

Do roof pitch and layers affect roofing costs?

Yes! Steeper roofs require more time and safety equipment—use a roof pitch multiplier. Also, multiple layers increase removal and disposal costs.

Can I estimate roofing jobs with templates?

Absolutely. Use roofing estimate templates to standardize pricing across jobs and ensure you account for all the costs like wood shingles, overhead, and labor hour.

How can I build a profitable roofing business?

Focus on accurate job costing, tracking roofing measurements, applying consistent profit margin percentages, and offering competitive roofing services. Modern tools let you price roofing jobs in just a few clicks.
